Worked examples — files included

Don't take our word for it. Open the files.

Three complete case studies, each with the actual files to download and run yourself. Every number is reproducible: same file, same seed, same result — on your machine, in your browser, with nothing uploaded anywhere.

Case study 01 · Full QSRA / QCRA

Tower C — Substation & Civils

16 activities · 5 risks · correlation group · costs loaded · pre/post mitigation

The flagship walkthrough: a substation and civils package with a groundworks-heavy front end, long-lead switchgear, and a commissioning tail. The plan says 24 Aug 2027. The simulation says that date is a 2% shot.

  1. Import & gate. The demo network enters through the Fitness Gate at READY (100/100) — closed logic, no hard constraints, no leads — so the P-values that follow stand on solid ground.
  2. Register. Five discrete risks with owners: ground conditions (40%, PERT 15/30/60d, mapped across the earthworks chain), a fragnet-mode utility consent delay, switchgear delivery, commissioning defects, and one opportunity (early possession). Each carries a cost impact and a priced mitigation.
  3. Ranges & correlation. Three-point ranges on every activity, plus a ρ=0.8 correlation group across the groundworks crew — because the same crew running late on one dig runs late on the next.
  4. Run. Latin Hypercube, seed 8812. P50 lands 10 Nov 2027, P80 3 Jan 2028 — 94 working days of exposure beyond the deterministic date, led by switchgear delivery and the ground-conditions risk.
  5. Cost. The QCRA layer carries £5.60m of base cost to £6.13m at P80, with the joint confidence "football" showing how often date and cost commitments hold together.
  6. Mitigation. Same-seed pre/post comparison: the £135k mitigation package buys the P80 back by 47 working days — ≈£2.9k per day saved. That chart is the business case for the risk budget.

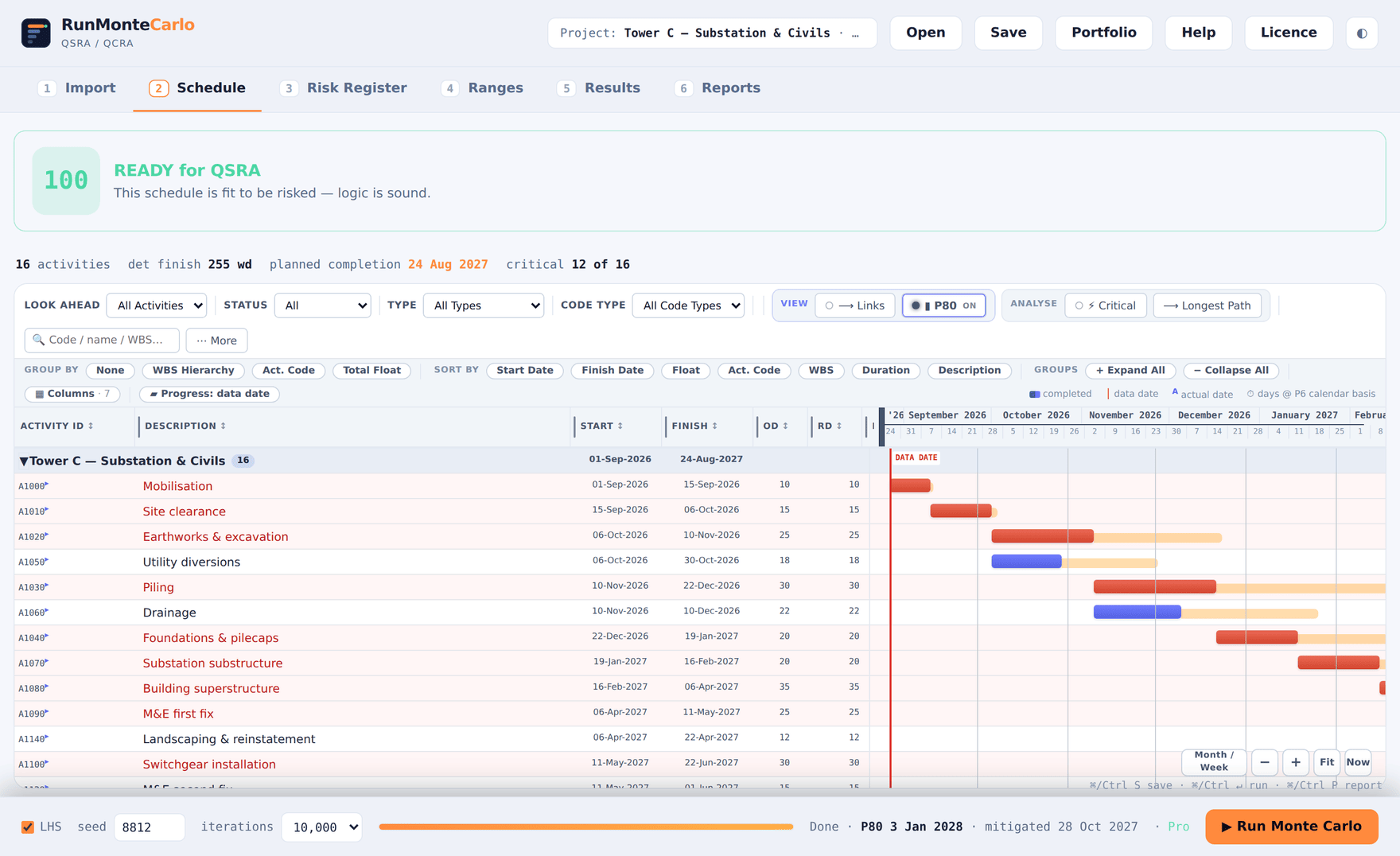

Tower C schedule view — per-activity P80 overlay on the Gantt
The Schedule view with the P80 overlay switched on: each deterministic bar carries an amber extension out to that activity's simulated P80 finish, critical activities picked out in the register alongside. Toggle it from the VIEW bar after a run.

Open the app → Open → pick the .riskproj → press Run with seed 8812. You'll reproduce every number above.

Open the app and try it →
Case study 02 · The monthly cycle

SUBSTATION-B — re-link on schedule update

P6 XER v1 → v2 · re-link · DCMA-14 gate · WBS · activity codes

QSRA isn't a one-off — it's a monthly rhythm. The month-two problem is always the same: the planner issues a new XER, and your carefully-built register and ranges point at last month's schedule. RunMonteCarlo's answer is re-link: drop the new file onto the existing Risk File.

  1. Month one. Import substation-b-v1.xer — a deliberately imperfect network. The DCMA 14-point gate catches what's wrong before you simulate: 33% missing logic, a lead, a hard constraint, 88% FS. Verdict: NOT RECOMMENDED — with each finding listed. (Risk it anyway if you choose; the gate is advisory and the caveats print in the report.)
  2. Build the risk model against v1: ranges, a risk on the steelwork, costs.
  3. Month two. Import substation-b-v2.xer — one activity deleted, one added, one duration changed. The re-link banner reports exactly what moved: activities matched (by ID, then code), ranges & costs carried over, risks kept, dead mappings flagged, new activities given default ranges.
  4. Re-run. Minutes, not a rebuild. That cycle time is the difference between QSRA as a living control and QSRA as an annual ritual.

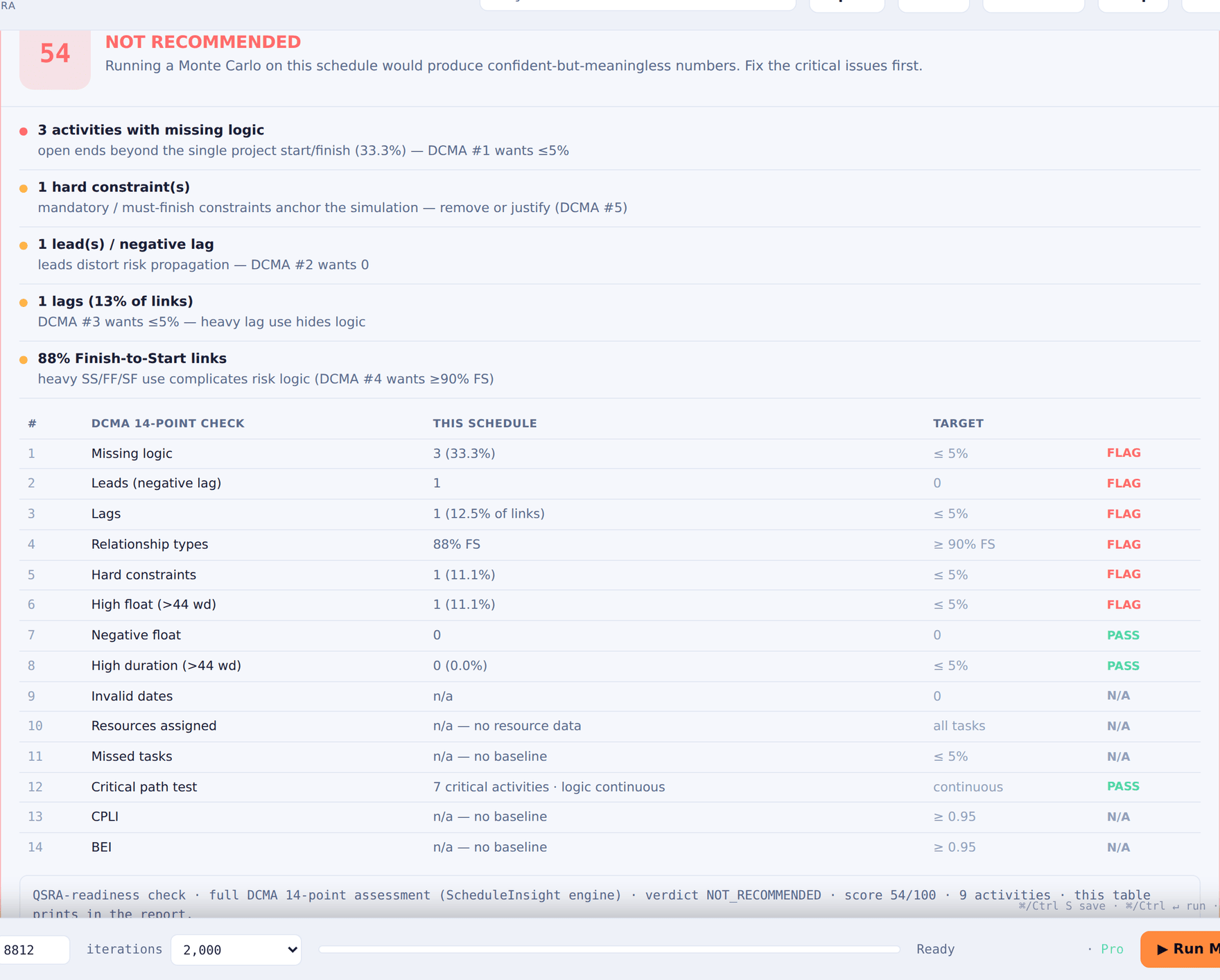

The DCMA 14-point Fitness Gate flagging deliberate defects in the v1 schedule
The Fitness Gate on v1: six FLAGs raised across the 14-point assessment, each explained — honest N/As where the file carries no baseline or resource data.

Import v1, add a risk or two, then import v2 over the top and watch the re-link banner do the month-two work.

Open the app and try it →
Case study 03 · Validation

Validation V1 — prove the engine against a closed-form answer

2 parallel paths · uniform durations · analytic CDF · merge bias

The strongest check on any simulation engine is a network whose answer is known exactly. V1 is two independent parallel paths — U(80,120) and U(70,130) working days, both planned at 100 — so the finish is max(A,B) and every quantile has a closed form.

StatisticAnalyticRunMonteCarloDifference
P50110.000110.075+0.075 d
P80119.102119.090−0.012 d
P(achieve day 100)25.0%24.9%−0.1 pt

It's also the cleanest demonstration of merge bias — the reason deterministic dates are optimistic: each path individually is 50/50 to hit day 100, but the project is only 25%, and its P50 is day 110. Ten days of slippage from geometry alone, before a single risk is added.

The full derivation, formulas and references are on The Maths → Validation. This check runs in our automated test suite on every engine change.

Open the app and reproduce it →
